How to Inspect RF-Welded Seams in Waterproof Bags Before Bulk Production

How to Inspect RF-Welded Seams in Waterproof Bags Before Bulk Production

Before approving bulk production, check whether every RF-welded seam is continuous, correctly positioned and free from lifting, wrinkles, burn-through and incomplete edges. Then confirm the result with an agreed seam-strength check and leak test.

Do not approve production if any part of the waterproof seam is open, peeling, burned through or leaking—even if the rest of the bag looks fine.

Here is the basic inspection logic:

What to checkAcceptable resultDo not approve if
Weld lineContinuous and correctly positionedGaps, missed areas or serious misalignment
Weld surfaceClean and reasonably evenBurn-through, pinholes or trapped contamination
Weld edgesCompletely bondedEdges lift or separate
Corners and intersectionsFlat and fully sealedWrinkles or gaps cross the sealing path
Strength checkSeam stays bonded under the agreed testPeeling, cracking or delamination occurs
Leak testNo leakage under the agreed conditionsBubbles, moisture or pressure loss appear

A good-looking weld is a useful starting point, but appearance alone cannot prove that the seam is strong or waterproof.

Start With the Approved Sample and Specification

Inspectors need something clear to compare against. “Make the seam strong” is not a measurable requirement.

Before checking the production trial units, confirm that you have:

  • The approved material specification
  • The approved sample or golden sample
  • The latest product drawing
  • The required weld location
  • The agreed weld width and tolerance
  • The required appearance standard
  • The agreed seam-strength check
  • The required leak or waterproof test
  • Clear pass/fail requirements

There is no single weld width, peel strength or test pressure that suits every waterproof bag.

A lightweight waterproof phone pouch, a roll-top dry bag and a heavy waterproof duffel place very different demands on their seams. The correct requirements depend on the material, bag design, intended use and waterproof claim.

The samples used for approval should also represent the planned production setup as closely as possible. That means using the intended bulk material, approved tooling and correct product construction—not a similar fabric or an earlier development sample.

For an explanation of the joining process itself, see how high-frequency welding works. If you are still deciding which seam construction is suitable, this guide compares RF-welded and seam-taped dry bags.

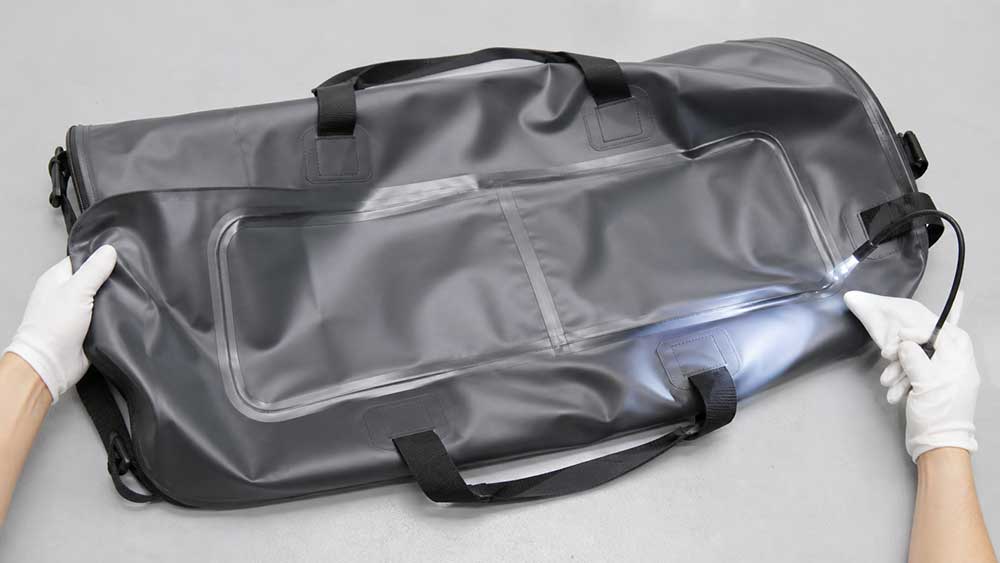

Inspect the Complete Weld, Not Just One Easy Section

Inspect the Complete Weld, Not Just One Easy Section

A long straight section may look perfect while the corner or end of the same weld remains weak.

Use consistent lighting and inspect the entire seam. Where possible, look at both the inside and outside of the product.

Pay particular attention to:

  • The beginning and end of each weld
  • Corners and curved areas
  • Weld intersections
  • Areas where several material layers meet
  • Bottom and side seams
  • Welds close to handles, straps, valves or patches
  • Any point where the seam changes direction

The weld should follow the position shown in the approved drawing. Its width should remain within the agreed tolerance, and the edges should stay completely bonded along the waterproof path.

Do not assume that a deeper or shinier weld is stronger. Different materials can produce different surface appearances. The relevant question is whether the weld matches the approved reference and passes the required tests.

Measure More Than One Point

Measure the weld at several locations rather than taking one reading from the middle of a straight section.

Check:

  • Weld width
  • Distance from the panel edge
  • Panel overlap
  • Alignment
  • Continuity through corners and intersections

A wider weld is not automatically better. If the material is pressed or heated too aggressively, the welded area may become thin, hard or damaged.

The goal is to reproduce the width and position that were validated during sampling—not to make the weld as wide or deep as possible.

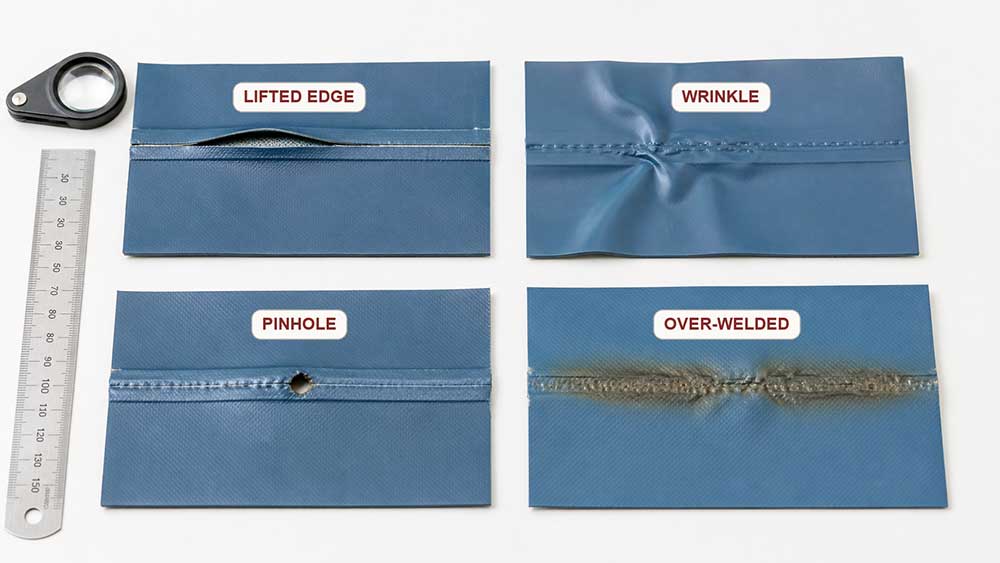

Know Which Defects Should Stop Approval

Know Which Defects Should Stop Approval

Some RF welding problems are easy to see. Others may only appear when the seam is flexed, pulled or leak-tested.

The table below focuses on what a buyer or inspector can observe and what to do next. The visible symptom may suggest a problem, but it does not always reveal the exact cause.

Possible defectWhat it may look likeWhy it mattersWhat to do
Under-welded or “cold” areaLight or uneven weld impression, lifting edge or a section that separates easilyThe layers may not be fully bondedHold approval and confirm with a strength and leak test
Over-welded areaExcessive thinning, deep marks, stiffness, distortion or discolorationThe material may crack or tear beside the weldReject affected pieces and review the machine setup
Wrinkle across the weldA fold passes through the waterproof sealing pathThe fold may create a small leak channelDo not approve until the area passes the required leak test
Burn-through or pinholeHole, scorched point, damaged coating or exposed base fabricThe waterproof barrier has been brokenReject the piece and investigate the process
Incomplete weld edgeGap, skipped area or interrupted bondingWater can enter and the edge may begin to peelCorrect the weld before approving production
Misaligned weldWeld is outside its intended path or does not leave enough overlapThe bonded area may be too narrowCompare with the drawing and hold approval if strength is affected
ContaminationDust, fibre, oil or another material is trapped in the weldIt may cause weak bonding, arcing or pinholesClean the work area and produce new test pieces
Weak corner or intersectionStraight seams pass, but a corner lifts or leaksCorners can fail during folding, loading or useCorrect the tooling, positioning or bag design and retest

Avoid diagnosing the cause from appearance alone.

For example, a weak seam may be connected to the material, pressure, RF energy, welding time, cooling time, tooling or contamination. The factory should investigate the variables one at a time and confirm the correction with new test results.

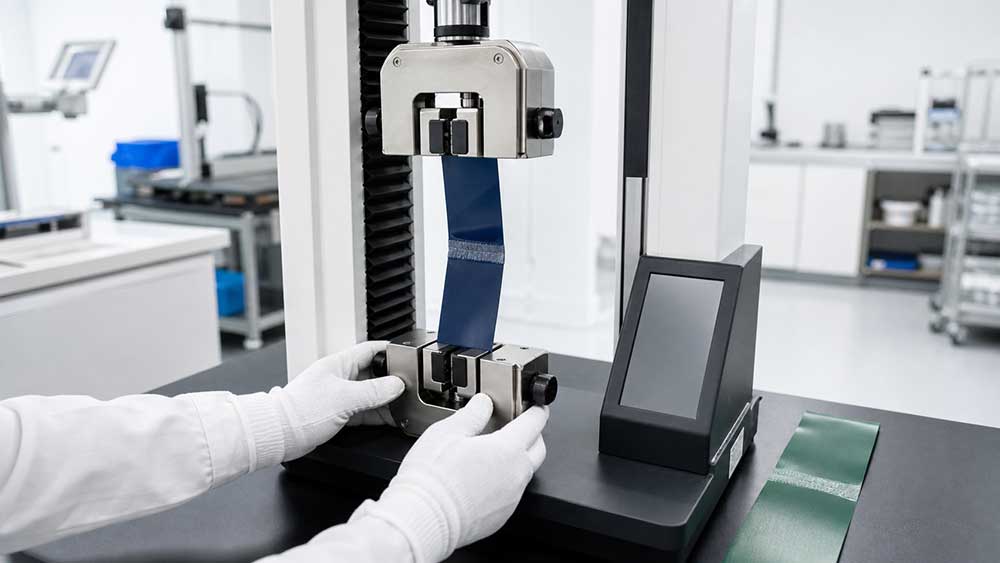

Check Seam Strength Without Relying on Hand Pulling Alone

Check Seam Strength Without Relying on Hand Pulling Alone

A gentle hand check can quickly reveal an obviously loose edge, but it cannot measure seam strength accurately. One inspector may pull much harder than another.

For initial screening, an inspector can:

  • Gently flex the seam in the direction it will bend during use
  • Check whether an edge begins to lift
  • Look for cracking, whitening or delamination
  • Compare the result with the approved sample
  • Record where any separation begins

Whenever possible, perform this screening on a test strip or designated sample rather than repeatedly pulling the finished approval sample.

For a measurable result, the buyer and factory should agree on a controlled test method. TWI explains that RF weld quality is often evaluated with a pull test or by examining the weld bead.

For coated fabrics, ASTM D751 includes test methods for seam strength and other relevant material properties. However, referring to ASTM D751 alone is not a complete acceptance requirement. The specification should also state:

  • How the test sample is prepared
  • Which direction it is pulled
  • How the result is recorded
  • What minimum result is required
  • Which type of failure is acceptable

The way the sample fails can be as important as the final force reading.

Record whether the failure occurs:

  • Inside the welded joint
  • Between the coating and the base fabric
  • Through the coating
  • In the fabric next to the weld
  • At a corner or weld transition

This helps determine whether the problem comes from the welding process or the material construction.

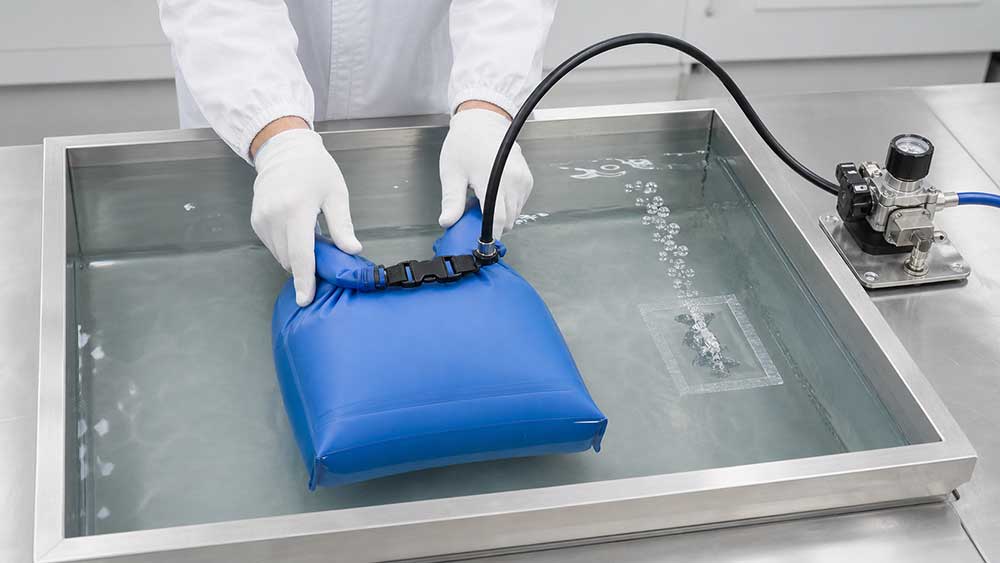

Confirm Waterproof Performance on the Finished Bag

Confirm Waterproof Performance on the Finished Bag

A seam can pass a visual inspection and still contain a hidden leak path. It can also be mechanically strong while the finished bag leaks through a corner, closure, zipper or valve.

The final check therefore needs to include the complete waterproof system.

Depending on the product, testing may include:

  • Air-leak or bubble testing
  • Pressure-decay testing for airtight products
  • Spray or water-exposure testing
  • Immersion testing under agreed conditions
  • Flexing followed by leak testing
  • Loaded handling followed by leak testing
  • Low-temperature conditioning followed by flex and leak testing

The test must match the intended use.

A waterproof phone pouch, kayak dry bag, soft cooler and inflatable product should not automatically use the same pressure, duration or immersion conditions. Do not apply an arbitrary internal pressure to a bag that was not designed to hold pressure.

The test report should clearly record:

  • Test method
  • Test duration
  • Water depth or pressure, if applicable
  • Product closure method
  • Sample identification
  • Pass/fail result
  • Location of any leakage

For a roll-top dry bag, even the number of folds matters. If that detail is not recorded, another inspector may close the same bag differently and get a different result.

A fabric waterproof test does not prove that the finished bag is waterproof. The seams, corners, zipper, roll-top, valve and attachments all need to work together.

Decide Whether to Approve, Hold or Reject

The final decision should be simple and evidence-based.

Approve Production

Production may be approved when:

  • The material matches the approved specification
  • The weld follows the correct path
  • Width and position meet the agreed tolerance
  • Corners, ends and intersections are completely bonded
  • No burn-through, open edge or contamination is present
  • Seam-strength checks pass
  • The finished product passes the agreed leak test
  • Appearance matches the approved standard

Hold Production

Hold approval when:

  • A wrinkle or surface variation may affect the sealing path
  • The seam looks acceptable but has not completed the required test
  • The material or tooling differs from the approved version
  • The cause of a failed result has not been confirmed
  • Corrective action has been taken but the new sample has not been retested

“Holding” does not necessarily mean rejecting the entire project. It means production should not continue until the uncertainty is resolved.

Reject the Sample

Reject the affected sample when:

  • The waterproof seam is open or incomplete
  • Burn-through or pinholes penetrate the waterproof chamber
  • The weld peels during the agreed test
  • The finished bag leaks
  • The weld falls outside a functional area shown in the drawing
  • The material has been damaged beyond an approved cosmetic limit

After correction, inspect and test a new sample. Do not approve production based only on a verbal promise that the settings have been changed.

Record What Was Approved

The factory and buyer should be able to identify exactly what passed.

A practical approval record should include:

  • Product name or SKU
  • Drawing version
  • Approved sample number
  • Material specification and lot
  • Tooling identification
  • Weld measurements
  • Test method and conditions
  • Actual results
  • Photos of important weld areas
  • Defects found
  • Corrective action
  • Retest result
  • Approval date

The factory may not disclose every proprietary machine setting, but the approved setup should be recorded and controlled internally. If the material, tooling or welding setup changes, the affected seam should be checked again.

The accepted production trial unit should be labelled and retained as a reference for the production line.

What Happens After Approval?

Pre-production approval shows that the selected setup can produce an acceptable seam. It does not guarantee that every later unit will be identical.

During bulk production, the factory should continue checking weld appearance, width, position and leak performance at an agreed frequency. Any failed test should trigger product isolation, investigation, correction and retesting.

Final AQL inspection may support the decision to accept a completed lot, but it cannot replace seam-strength or leak testing. Functional waterproof requirements need their own inspection plan.

RF seam inspection is also only one part of a complete waterproof bag quality inspection. Materials, closures, hardware, straps and finished dimensions still need to be checked.

Pre-Production RF Weld Checklist

Before approving bulk production, confirm that:

  • The production material matches the approved specification
  • The correct material surfaces are being welded
  • The latest drawing and tooling are being used
  • The weld is continuous and correctly positioned
  • Width remains within the agreed tolerance
  • Corners and intersections are completely sealed
  • No edge is lifting
  • No burn-through, pinhole or contamination is present
  • The seam passes the agreed strength check
  • The finished bag passes the required leak test
  • Any failed result has been corrected and retested
  • The approved production sample has been recorded and retained

If any functional requirement is still unclear, do not approve bulk production yet.

How Vancharli Outdoor Approaches RF-Welded Bag Inspection

At Vancharli Outdoor, our waterproof bag manufacturing process can include material confirmation, weld-layout review, production trial inspection and product-specific waterproof testing, depending on the bag design and performance requirement.

The goal is not simply to produce a seam that looks neat. The material, weld position, tooling, machine setup and testing method need to work together and remain consistent during production.

For dry bags, waterproof duffels, pouches, soft coolers and other welded products, these requirements are best agreed during sampling—before a quality problem reaches bulk production.

Final Thoughts

Inspecting an RF-welded seam does not need to be complicated.

Start with the approved sample and specification. Check the full weld, especially its edges, corners and intersections. Look for incomplete bonding, wrinkles, burn-through and misalignment. Then confirm the result with an agreed strength check and a leak test that matches the finished product.

A clean appearance is useful, but production should only be approved when the seam is correctly positioned, stays bonded and keeps water out under the agreed test conditions.

Frequently Asked Questions

Can an RF-welded seam look normal but still leak?

Yes. A small gap, wrinkle or incomplete bond may be difficult to see. That is why visual inspection should be followed by an appropriate leak test.

Is a deeper weld mark a sign of greater strength?

Not necessarily. A very deep weld may indicate that the material has been excessively compressed or damaged. Compare it with the approved sample and confirm the result through testing.

Is hand pulling enough to check the seam?

No. It can identify an obviously loose edge, but it cannot provide a consistent strength measurement. Use an agreed test method when a measurable result is required.

Must every waterproof bag be immersion-tested?

No. The test should match the product’s intended use and waterproof claim. A splash-resistant pouch and a dry bag intended for temporary immersion require different test conditions.

Should a wrinkle always cause rejection?

Not always. A wrinkle outside the waterproof path may only be cosmetic. A wrinkle crossing the complete welded path may create a leak channel and should be tested before approval.

Can AQL inspection replace waterproof testing?

No. AQL inspection can support lot acceptance, but it does not prove that a seam is strong or watertight. Waterproof performance requires a separate, clearly defined test.
